This document is to seek for the opportunity to build Software Process Improvement (SPI) plan document for eOne in developing a light Enterprise Resource Planning (ERP) software as an enterprise solution to the market in Indonesia. This documents shall deal with,
This document builds complete software process improvement plan for eOne in developing and maintaining a light ERP software. This software development process improvement document can be reused for similar projects in the future in developing the enterprise solutions for small and medium organization.
Table 1 describes acronyms, abbreviations, and description used in this document.
Table 1. Acronyms & Abbreviations
Acronym | Description |
---|---|
E1 | EnterpriseOne, Oracle owned ERP software which directly competes with SAP in United States |
ELG | Executive Leadership Group |
ERP | Enterprise Resource Planning, which is backbone system for company with integrated features |
FDD | Feature-Driven Development |
GQM | Goal-Question-Metric, or Goal-Question-Measurement |
IDEAL | Initiating, Diagnosing, Establishing, Acting, and Learning, software process model developed by SEI in 1996 |
IEC | International Electrotechnical Commission, the international organizations for standardize electrical, electronic |
IPO | Input Process Output for software engineering diagram |
ISO | International Organization for Standardization, an international standard-setting body comprises representatives from different national standards organizations |
IT | Information Technology |
MRP | Material Resource Planning, the original of ERP software |
MSG | Management Steering Group, or steering committee to manage projects |
MVC | Model, View, Controller. Design pattern which segregates data, logic, and interface |
PATs | Process Action Teams |
QIP | Quality Improvement Paradigm |
RMP | Risk Mitigation Plan |
SCM | Software Configuration Management |
SEI | Software Engineering Institute, the Carnegie Mellon Software Engineering Institute which is funded by federal government |
SEPG | Software Engineering Process Group, an organization, focusing on software process improvement activities |
SLDC | Software Development Life Cycle, the life-cycle of software development which encompasses planning, analysis, design, implementation, and maintenance |
SPI | Software Process Improvement, the framework to improve software process |
SPICE | Software Process Improvement and Capability Determination alternatively names ISO/IEC 15504 |
QA/QC | Quality Assurance/Quality Control in engineering process |
SQA | Software Quality Assurance, monitoring the software engineering process and methods |
SQC | Software Quality Control. Cf., QC (Quality Control in Assembly line) |
Note: this table is to be updated when plan gets moving on.
eOne is a small consulting firm focusing on Enterprise Resource Planning (ERP) software consulting with 100 employees in various cities in Indonesia. The organization comprises mainly three areas – management, business analyst, and developers.
This project seeks for the opportunity to improve the software process in developing light ERP software through reviewing existing process models, practices, Software Process Improvement (SPI) frameworks, and building the organization specific SPI model/framework for effective development and maintenance of light ERP software.
Process is means to produce a product through the integration of tools, people, and procedure in engineering process. Software process is the set of practices and tasks to build and enhance software, which is the sequenced and organized tasks to be performed by a procedure (Saiedian, 2005). The purpose of process model is to produce quality software timely within its budget. Here reviews the industry accepts software process improvement (SPI) methods, its advantage and disadvantage, and selection of SPI methods for this project.
SPI is essential to improve the quality of software, where the software improvement can be accomplished using SPI methods. SPI is a framework to identify potential problems and inefficiencies in Software Development Life Cycle (SLDC) to implement and to devise possible solutions through proper analysis and improvement of software development process.
Some of well perceived methods are Six Sigma, IDEAL model, Software Process Improvement and Capability Determination (SPICE) model, Capability Maturity Model (CMM), International Organization for Standardization (ISO) model, and lastly Sprint in Agile Software Life Cycle.
As a federal funded research and development center, the Software Engineering Institute (SEI) develops IDEAL model in1996 for software process improvement, which is named by the initial of five phases - Initiating, Diagnosing, Establishing, Acting, and Learning phases. Figure 1 depicts five phases in detail (McFeeley, 1996).

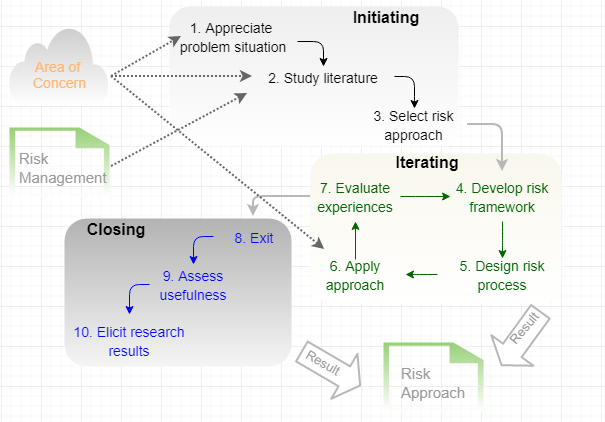

Figure 1. The IDEAL Model
The advantage of IDEAL model is various disciplines which suits for long-term improvement strategy. As figure 1 reads this method is a continuous improvement model (Anees, 2017). IDEAL model supplements the process improvement plan in the long run. So this process model will be adapted in implementing a hybrid approach between maturity approach and agile approach for eOne to develop software process improvement plan.
The International Organization for Standardization (ISO) and the International Electrotechnical Commission (IEC) introduced the working title named SPICE (Software Process Improvement and Capability Determination) or ISO/IEC 15504 in 1993. The SPICE model comprises the process dimension and the capability dimension where the process dimension includes customers-suppliers (CUS), Engineering (ENG), Project (PRO), Supports (SUP), and Organizations (ORG) (HM&S, n.d.). On the other hand, the capability dimension is depicted in figure 2.
Figure 2. The Capacity Dimension in SPICE Model
The advantage of SPICE Model is that the organization can focus on a specific process for the area of development rather than the models works iteratively. SPICE model has enhanced the rigidity of maturity model however the capacity model of this model does not suit for eOne as a small organization where teams are segregated by functions.
The Capability Maturity Model (CMM) is developed in 1991 by Carnegie Mellon Software Engineering Institute (SEI) to help the organization improve the process in developing software. This model attempts to integrate the rich asset of capability models based on the notion of process maturity, which evolves to an integrated capability model (CMMI). So CMMI supersedes CMM framework and integrates it with other capacity maturity model to overcome weakness of CMM. Some literature categorizes it into the staged CMMI model and the continuous CMMI model. The latter does not classify the organization per discrete levels, unlike earlier CMM model. Figure 3 depicts the process area defined in the managed level in the staged CMMI model (Sommerville, 2016).

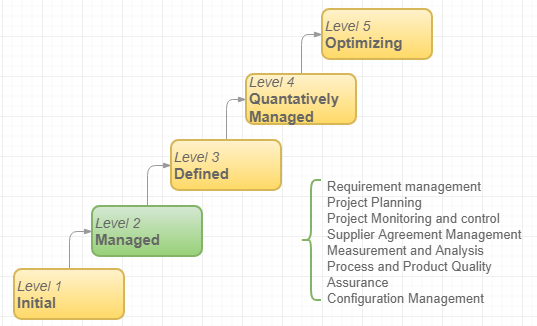

Figure 3. The CMMI Staged Maturity Model
The disadvantage of the staged CMMI model is that each maturity level has its own goals and practices and assumed all these goals need completing before moving on to next phase. The overcome this advantage, the continuous CMMI model is available. CMMI process model is to be discarded for actual implementation of process model because eOne is too new and small organization to implement this.
Agile determines documentation does not help to improve the development process supposing that the requirements continuously changing supposing that the process improvement is resulted from work improvement. In this context, the main goal of Agile model is to able you to reach there step by step, or repeating the iterative nature of software development incremental shape as depicted in figure 4.

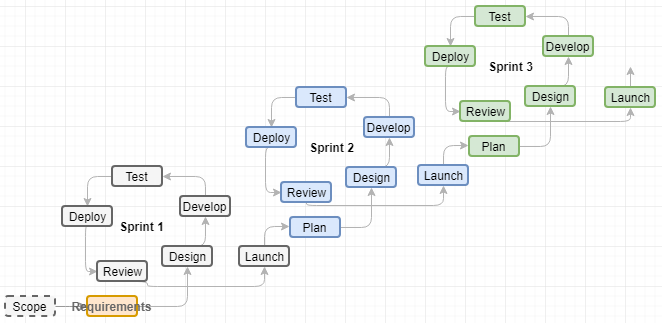

Figure 4. Sprints in Agile Methods
Supposing that change must be adaptive, Agile methods are the natural choice for change project. Study shows that a CMMI maturity level is significant improvement which takes roughly takes two years where this time frame naturally induces changes including new products, new competitors, and restructuring of organization (Foegen et al., 2009).
There are two distinctive approaches to meet the goal of software development process improvement. One is the maturity approach, which focuses on process improvement and project management by introducing good software engineering practice to an organization with goals of improving product quality and the predictability of process. Generally, the process maturity approach is based on plan-driven development which increases overhead, as result, activities do not translate into programming activities. Another is the Agile approach, which emphasizes the overhead reduction in software development life cycle (SLDC) with characteristics of rapid delivery of functionality and responsiveness to the change of requirements. Agile approaches focus on the code to develop by minimizing formality and documentation (Sommerville, 2016).
eOne is a small organization in developing a light ERP software where a light ERP has the architecture style is a layered style with its pattern – Model, View, and Controller (MVC) to develop various features in composite design pattern. Since ERP comprises multiple modules which repeats its pattern, I believe Agile approach for the software process improvement is well suited.
Through Agile approach, eOne can (Foegen et al., 2009),
The adhesion of a single approach may cause the project failure. It is important to adopt the vision, goals and status quo from maturity approach to produce quality product on time without exceeding budget even the Agile approach is proved to be most cost effective for small project for eOne and IDEAL suits as framework of process improvement. The reason for this argument is that the Agile approach may lack of the improvement in the life cycle independent process improvement which encompasses management (project management, quality management, and risk management), support (documentation, configuration management, quality assurance, and problem resolution), and customer-supplier (customer need management and customer support).
Process model is to build quality software reasonably close to on time and without exceeding project’s budget. There are various process models to meet this goal. Some literature categorize prescriptive and non-prescriptive, or predictive and adaptive, others categorize it predictive (Waterfall, Waterfall with feedback, Incremental Waterfall, V-model), iterative (Prototypes, Spiral, Unified process, Cleanroom), and rapid application development (Agile, XP, Scrum, Lean, Crystal, Feature Driven Development, Agile Unified Process, Kanban). A certain process model gains popularity over another when it overlays the disadvantage of other process model (Stephens, 2015). Possible diagnostic methodology can follow the problem identification, effective solution identification, implement best solution, and finalize knowledge (implement and communication solution).
Functional areas segregate the teams in eOne, which is based on the ERP suites as depicted in figure 5. Each team has five business analyst and ten developers where units includes Material Resource Planning (MRP), Shop Floor, Sales, Procurement, Account Receivable, Account Payable, General Ledger, Human Resource & Payroll, and other minor suites.

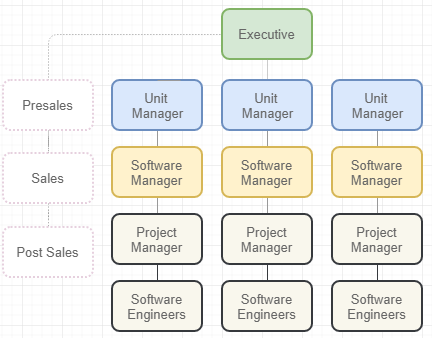

Figure 5. Current eOne Organization
This organization structure gives room for different approaches in software development process depending on the expertise of software managers. As result, current approaches which do not have common practices agreed upon have issues,
The advancement of IT infrastructure in the region gives the opportunities for eOne to move forward from the traditional software development methodology. Figure 6 depicts the design process model – waterfall for software develoment lifecycle.

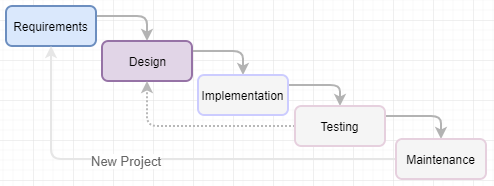

Figure 6. Waterfall Process Model
In this model, the requirements are precisely known in advance which huge amount of documentation, which will not change much during development.
However, the waterfall process model has some known disadvantages which sometimes affect the project success to meet the budget and time limitation. This rigid process model has disadvantages,
The benchmark and reverse engineering approach reveal that current commercial ERP software can be characterized with the Layered Style using Model-View-Controller (MVC) pattern, where package is the combination of features with the composite design pattern. And each features are tightly integrated as depicted in Figure 7.

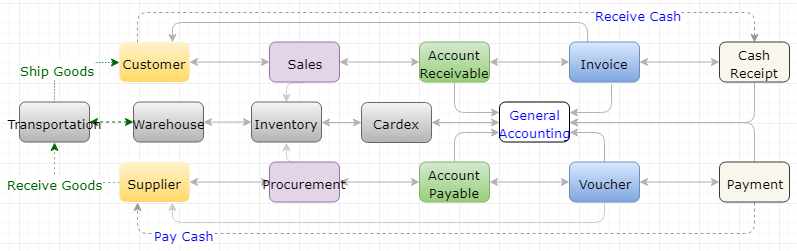

Figure 7. ERP Integration
To implement a light ERP with above software architecture in mind, here review the process models: Reverse Engineering for software reuse, Scrum and Feature-Driven Development (FDD) as agile approaches to overcome the disadvantage described in waterfall process model.
Reverse engineering is a procedural effort of understanding, duplicating an existing software Oracle’s JD Edwards EnterpriseOne (E1), or components without using diagramming, modeling, or documentation through analysis of existing system (Singhal & Gandhi, 2014). It is hard to build the whole source codes for the enterprise solutions from scratch when time and budget are limited. Hence, reverse engineering is viable option for the project to build a light ERP software which is slimmed down version of E1 based on the expertise of business analysts and developers to build quality software without compromising its functionality.
This approach aims to enhance the proven and existing enterprise solution by simplifying existing package through reverse engineering tool. This tool encompasses software maintenance, re-use, re-engineering, evolution, and testing.
Feature-Driven Development (FDD) is another incremental and iterative development model in Agile approach to accomplish comprehensive software using five phases depicted in (TatvaSoft, 2015). The five phases comprises developing model, building a feature list, planning by feature, designing by feature, and building by feature.

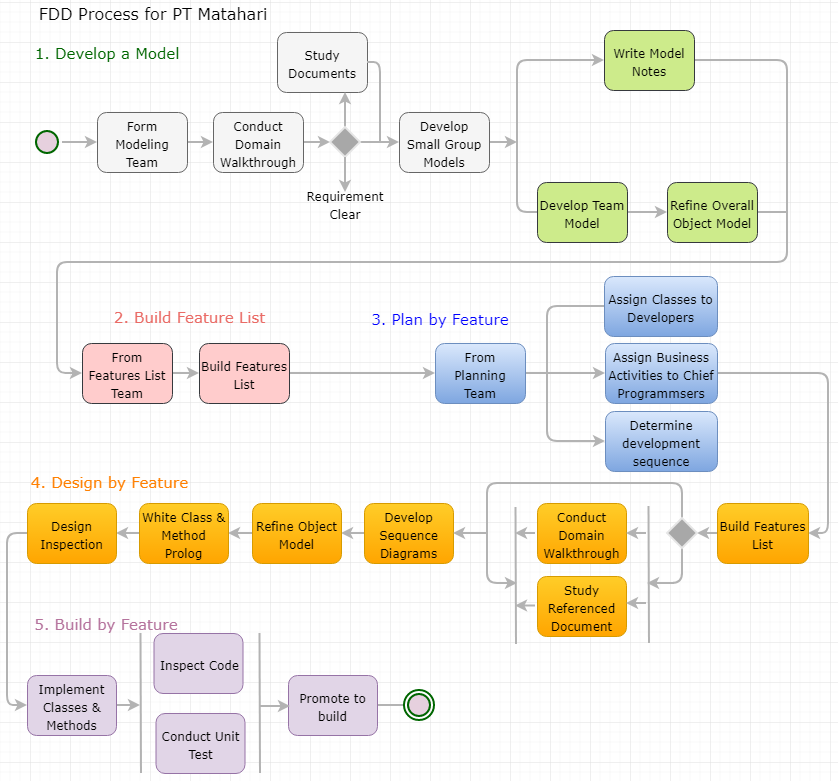

Figure 8. Feature-Driven Development
The reason for choosing this development model is that the ERP software is built based on the collection of comprehensive features to record and manipulate daily transactions without fail even it is a light one. The nature of ERP lies in its composite pattern using composite (can have other object underneath) and leaf (very last object in a tree) which has iterative and incremental nature by itself.
The Scrum development methodology can be applied to almost any project when the requirements changes rapidly (TatvaSoft, 2015). In Scrum, the person who brings the software to life is the product owner who is responsible for the software through its life cycle. This scrum approach deals with vision, value, and validation in the hierarchy which starts from company vision, business strategy, production vision, product strategy, release plan, sprint plan, and daily plan in top down approach.
One of essential component of Scrum is Sprint. The Sprint is a time-box of a month to complete runnable product. Each Sprint can be considered as a small project which is a small program in the ERP suite. In this approach, the Sprint is a kind of the feedback loop to the product owner who creates the program.

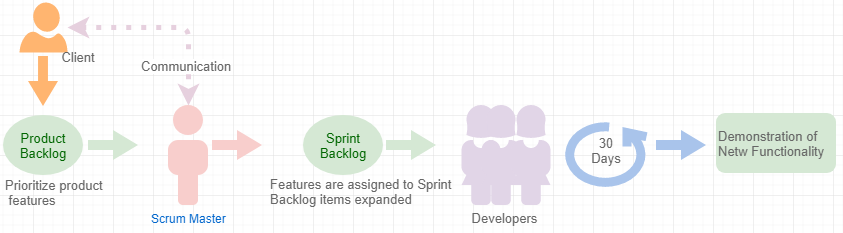

Figure 9. Linear View of Scrum Methodology
Scrum framework depends on pillars – transparency (regarding visibility), inspection (on Scrum artifacts and progress toward a Sprint Goal), and adaptation reads (including Sprint planning, Daily Scrum, Sprint Review, and Sprint Retrospective) as the Scrum Guide reads. As depicted in figure 9, basic elements of Scrum approaches are (McGreal & Jocham, 2018),
The light ERP software of eOne to develop is a series of iteration. For instance, sales order entry comprises various validation on customer and item. And the validation of item extends to item price, cost and so forth. Hence, this development model suits for building software with huge number of components/iterations.
As reviewed earlier, current development process – Waterfall development process is not suitable for comprehensive software development. Hence, three development process with focus on software process improvement are,
All three approaches are essential to build a light ERP software successfully and accomplish the software process improvement.
The software process improvement plan is ongoing project by choosing right process models which are most suitable for eOne. IDEAL and three process models for strategic level and tactical level are chosen for the success of project.
The organization need evolving as depicted in figure 10 which is evolved form based on figure 5.
Figure 10. Revised Organization for SPI
In this figure, the practice suggested by IDEAL model got applied to accomplish the software process improvement which is align with software development models in building a light ERP software for eOne. In this steps, eOne builds the infrastructure for successful software process improvement as below (Layman, 2005),
The purpose of communication plan is to make sure that ongoing software process improvement plan is relevant, accurate, and consistent to project stakeholders and other audiences to gain support and cooperation from each stakeholders as well.
Commonly, the development of communication action plan comprises the processes as depicted in figure 11 (MITRE, n.d.).

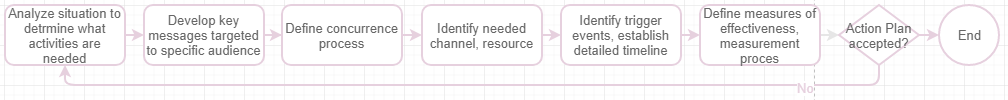

Figure 11. Communication Action Plan
Open and effective communication including both top-down and down-top to meet,
Table 2 represents the target audiences for the effective communication based on the organization depicted in figure 9.
Table 2. Communication Purpose per Target Audiences
Audience | Communication Purpose |
---|---|
Executive & Executive Leadership Group (ELG) | Project plans, progress, and approval |
Unit Manager & Management Steering Group (MSG) | Project strategy, direction, project deliverables, and changes |
Project manager and Software Engineering Process Group (SEPG) | Project strategy, policies, deliverables, Impact Analysis, and progress |
Business Analyst, Developer & Process Action Team (PATs) | Impact analysis, detail design/test plan, and execute the process |
Table 3 describes possible communication approach based on audience and purpose defined in table 2.
Table 3. Communication Approach
Audience | Message | Distribution Method | Frequency of Distribution | Sender |
---|---|---|---|---|
ELG | Project Plan & Status Reports | Meeting | Weekly | Project Manager |
MSG | Project Plan & Status Reports | Meeting | Weekly | Project Manager |
SEPG | Status Report & Project Briefing | Meeting | Biweekly | Project Manager |
PATs | Project Briefing | Meeting | Monthly | Project Manager |
Effective and open communications are vital elements for project success by visualizing the vision and direction of the project.
The assumption made so far is that a good software process results in a high quality software, nearly on time without exceeding its budet based on SPI enviornment in figure 12.

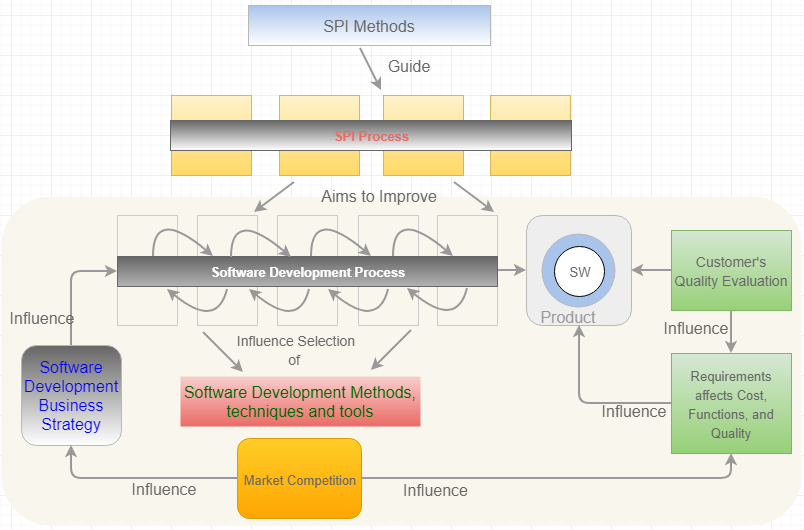

Figure 12. SPI, Software Development, and Software Quality
The SPI initiatives comprises frameworks, practices, and its tools used. Frameworks help the organization to prioritize its improvement and to focus on the area where more attention is needed. Practices are performed and planned software engineering practices during software development lifecycle (SDLC). And tools help Software Process Improvement (SPI) project to utilize requirements management, scripting for automation, and configuration management (Islam& Unterkalmsteiner, 2009). This posting reviews the methodology for metrics, metrics to use, challenge of selected methodology, and its solution.
Table 4. SPI Framework and Measurement Methodology
SPI Management | Development Model | Process Quality Appraisals Standards | Measurement Methodology |
---|---|---|---|
IDEAL with Agile approach | Reverse Engineering, Feature-Drive Development, and Scrum | CMMI | GQM |
Note: GQM is Goal/Question/Metric Method which to be described further.
Table 4 is simplified view of Software Process Improvement project in developing a light ERP software for eOne. The objectives of these metrics are to assess the project scope, to control the cost of development, and to ensure project cost within budget respectively. Figure 13 depicts the goal of SPI using Quality Improvement Paradigm (QIP) in the organization which can be utilized for eOne.
Figure 13. Corporate Goal and Project Goal
The metrics, the quantitative measurement of software quality, determine the quality of software, which can be categorized into size, productivity, rework, effort, schedule, and quality, which are highly dependent on the capability maturity level of the development process during the software development lifecycle (McAuley, 1993). There are various measurement frameworks available where a measurement frameworks is a set of related metrics including data collection mechanism, and data uses in software (Mendonca et al., 1998).
Table 5 describes metrics to measure software development activities to use for software process improvement plan for eOne.
Table 5. Measurement Detail
Metrics Category | Question | Measurement |
---|---|---|
Size Metrics | Current size of the requirement status | Total number of requirement completed vs. planned |
Current size of design status | Number of design completed vs. planned | |
Current size of new and reused code | Line of code completed vs. planned | |
Current size of test size | Number of test completed vs. planned | |
Current size of documentation | Number of pages completed vs. planned | |
Cost & Resource Metrics | Current cost by activity | Number of Labour Hour spent vs. estimated |
Number of dollar spent vs. estimated | ||
Current budget status | Number of labour hour spent vs. estimated | |
Number of dollar spent vs. estimated | ||
Schedule Metrics | Current Development Time | Elapsed time vs. estimated time |
Current schedule status | Number of milestones completed vs. number of milestones planned/estimated | |
Quality Metrics | The Nature of defects | Number of defects per severity |
The defect density | Number of defect per metric size | |
Quality of the defect detection process | Number of pre-release defects vs. Total number of defects (pre-release + post-release) | |
Product reliability | Number of defects vs. execution time |
The development project of light ERP software project is to establish a baseline for the measurement of SPI for eOne. Hence these metrics are to be analysed and assessed throughout software development lifecycle.
This section reviews overall measurement plan encompassing how to collect it and who does the collecting it, how to analyse and evaluate it by reviewing the metrics chosen above. Table 6 entails the definition of metrics and its measurement.
Table 6. Metrics Definition & Its Measurement
Metrics | Definition | Measurement |
---|---|---|
Size | Software size is the indicative of the effort required against planned effort. | Software Lines-of-Code (SLOC), Function Point Size, and Feature Point Size |
Cost and Schedule | US Department of Defence (DoD) determines the schedule and cost are always contradictory. The aim is to control the cost and schedule of software development effort. | Schedule Measurement, Milestone Measurement on Human resource, hardware resource, software resource, and reusable resources. |
Quality | Software Quality is to ensure the quality of the software is right based on both functional and non-functional requirements. | Reliability, maintainability, integrity, usability, performance, availability |
Note: Cost Metrics and Schedule Metrics are combined here because these factors are tightly related and intertwined.
Table 7 gives the detail view of the source of data collection and collector for chosen metrics. The main concern of light ERP software development is budget and time factor by putting the focal point to the features in the system. It can be good approach to assess the improvement through benchmark based on similar software development project when applicable.
Table 7. Metrics Data Source & Collector
Metrics | Data Source | Collector |
---|---|---|
Size | Software Development Project Schedule including requirements, design, coding, and testing. | Project Manager |
Cost and Schedule | Budgeting and weekly meeting | Project Manager |
Quality | Software development team, testing records, engineering lab test, source codes, and code review result. | Project Manager and developers |
Analyzing the collected measurement data is essential to generate the indicators for improvement. In other words, indicators are derived from the performed analysis on measurement data. Commonly, both objective and subjective data analysis help management to analyze the improvement. The objective data comprises staff hours, SLOC, function points, components, test items, units codes, changes, or defects. And the subject data encompasses level of problem difficulty, degree of new technology involved, stability of requirements (Acqnotes, 2013).
The evaluation of the effectiveness of the measurement is important through examining the correlation between the goal attainment and measurement results as depicted in figure 14. In this figure, both database in core measurement process and experience data describe how the iteration of plan, perform and evaluation works (Islam & Unterkalmsteiner, 2009).

Figure 14. Evaluation in Measurement Process
The GQM methodology or Goal-Question-Measure approach which is built on Quality Improvement Paradigm (QIP) aims to supply information required for changing, guiding, and understanding the software process of a software development project in the organization. This methodology represents both a top-down approach and a bottom-up approach. The former is to define and collect measurement, and the latter is to analyze the data collected against stated measurement goals. GQM integrates the goal of organization into measurement goals and entails measurable attribute on step-by-step basis. Hence, GQM contributes to identify the exact metrics needed based on measurement goal, not the software best practice (Komi-Sirvio, 2004). In this context, software measurement compasses the quality of software as a product (product measures), process performed (process measures), and resources used (resource measures). Figure 15 depicts a brief overview using size metrics and quality metrics in building a light ERP software for eOne for the first time.

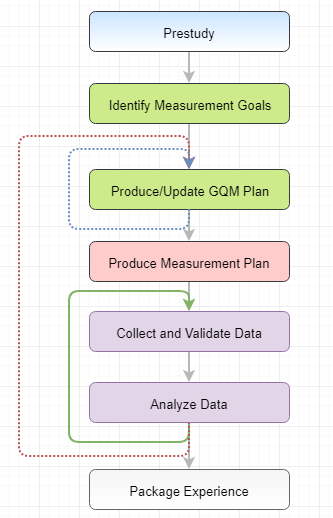

Figure 15. GQM as Data Collection Methodology
The complexity and uncertainty of implementing metrics program makes whole SPI project skeptical. Especially, it is hard for eOne to choose right measurements since this organization does not have sufficient software development experience. As table 8 represents, challenges vary depending on metrics patterns including measurement itself, people, program, and its implementation (Iversena & Kautzb, n.d.).
Table 8. Metrics Program Challenges
Category | Challenge | Resolution |
---|---|---|
Measurement | Aim too big | Start small |
Low conformance | Use a defined set rigorously | |
Tedious data collection and reporting | Automate it | |
People | Unmotivated managers | Motivate managers |
Undefined expectations | Set clear expectation | |
Missing communication loop | Involve all stakeholder | |
Lack of training | Educate and train people involved | |
Overwhelming mistrust | Build trust | |
Program | Lack of available methodology | Take evolutionary approach – Agile for instance |
Stick to the original program | Agile to throwaway | |
Missing information | Get right information to the right people | |
Overly time consuming initiative | Strive for a small initial success | |
Implementation | Too much effort without any outcome | Add value |
Alienation of developers on the use of measurement information | Empower developers to use measurement information | |
Missing holistic view | Take holistic view of project | |
Impatience to have result | Apprehension of new adaptation takes time | |
Five factors in SPI project need considerting to to overcome the hinderance in the measurement of SPI inititiave (Iversena & Kautzb, n.d.).
The software development process gets more disciplined, motivated by the notion that the quality of software is affected by the quality of the process where the process is defined, agreed, followed, and enforced. Assessing the SPI outcomes is as important as the implementation of SPI because the gain of its initiative can be measured only through this activities. SPI improvement project is a new paradigm for eOne who acquires industry best practices to fulfil SPI initiatives.
This section reviews how Software Quality Assurance (SQA) process positively affects the improvement of software development process, which resulted in the quality software. This section covers what is SQA process, relationship with process improvement, and its implementation. High level SQA can be represented in figure 16, which justifies how SQA can contribute to the improvement of software development process.
Figure 16. SQA & Process Improvement
Below reviews how SQA helps eOne build quality software by complying some SQA process model available.

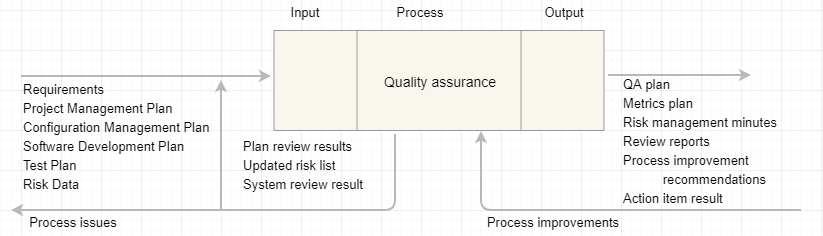

Figure 17 depicts a simple view of the Software Quality Assurance (SQA) process using input-process-output (IPO) diagram. This model comprises eight sub-processes comprising: 1. Review project level plans; 2. Develop Quality Assurance (QA) plan; 3. Coordinate its metrics; 4. Coordinate risk program; 5. Perform audits; 6. Coordinate review meetings; 7. Facilitate process improvement; and 8. Monitor test program (Drabick, 2000).
Figure 17. SQA Input-Process-Output Diagram
SQA assures that the function of software quality including the standards, processes, and procedures are appropriate for the project and are implemented correctly. Here reviews the requirements development, product integration, and validation in detail where CMMI identifies the process improvement processes with requirements development, requirements management, technical solution, product integration, verification, and validation (Fleming, n.d.).
Any software development process starts from requirements elicitation, which encompass customer requirements, product requirements, and product-component requirements. SQA plays important role to determine the compliance of documented standards, processes, and procedures. In building a light ERP software for eOne, the design methodologies - reverse engineering, feature-driven development, and Scrum is used. In this process, the elicitation and analysis of requirements are based on existing commercial software, Oracle’s JD Edwards EnterpriseOne (E1). In the phases of requirements during SDLC, the business analysts review the functionality of exiting software and suggest the features may not be useful for small and medium sized enterprises.
The goal of ERP implementation is for integration, which integrates the components to the higher program, in the suites, or between suites. The transactional data of supply and demand resulted in Material Resource Planning (MRP) and sales order updates account receivable for instance. Hence, the integration is one of core process in developing ERP software and integral part of integration is bigger than sum of individual applications. In product integration of SQA ensures that the product/package, as integrated functions correctly. Also, SQA makes sure that documented standards, processes, and procedures are followed. Nonetheless, it is equally important the role of Software Quality Control (SQC) to perform the System Integration Test.
Validation is the process to check you have built a right product and verification is to determine the product built is right. Both processes are more relevant to SQC realm, but this process is equally important in building the enterprise solutions. Because the enterprise solution comprise huge number of programs towards suites, hence the important of verification and validation are paramount.

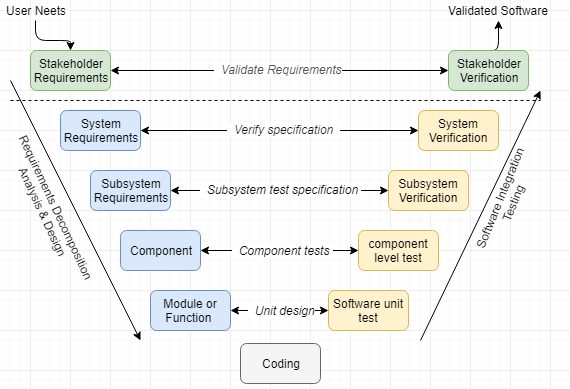

V-model represents clear semantics even when V-model is not the choice of design methodology in developing a light ERP. As depicted in figure 18, the top represents validation where below validation processes show verification (Mehle, 2017).
Figure 18. V-Model for Validation and Verification
In verification process, SQA plays an important role to check SQC has documented plan, procedures including to determine the effectiveness of verification process. In validation process, even it is very much SQC domain, SQA validates whether the test and feedback conforms the documented procedure and process. These processes highly impacts the continuous improvement and measurement.
The change of development processes results in some deficiencies which is the exposure of unfavourable outcome. This section reviews deficiencies and its counter measure to accomplish process improvement (Shang & Seddon, 2007). Since the project for software development is a light ERP, table 9 represents sources of deficiencies and its counter measure using SQA model.
Table 9. Deficiencies & Process Improvement using SQA
Category | Challenge |
---|---|
Configurability |
|
Integrity |
|
Streamlined processes |
|
Multiple options |
|
Standard processes |
|
Performance |
|
Note: Deficiencies above are common features of ERP software.
The process improvements apply to the organization for continuous improvement, software development project for baseline of process improvement, and software development process for efficient development based on the assumption that the process improvement and SQA models resulted in quality software.
As depicted in figure 17, SQA encompass all below sub-processes. Table 10 is written based on CMMI process model which is self-explanatory in modelling how to communicate each improvement (Drabick, 2000).
Table 10. Process Model of SQA & Communication Plan
Process | Sub-process | Communication Plan |
---|---|---|
Review Project Plan | Review project management plan, Review the configuration management plan, and Review software development plan | These are components for high level SQA, which is to be performed the organizational level. This process is baseline for continuous improvement. |
Develop QA plan | Develop QA plan introduction, Create management section, Identify documentation requirements, identify standards, Specify reviews and audits, Review CM interface, Review defect reporting, Develop metrics strategy, Identify tools and techniques, Define supplier control, Define record approach, Document SQA plan, and Review and approve SQA plan | Allocate most of SQA activities in this process. SQA group creates cost and schedule estimates of project and generate reports to share its plan. |
Coordinate Metrics | Develop metrics strategy, Create metrics database, Document metrics plan, Review metrics plan, Collect measurement data, Compute metrics, Evaluate trends, Issue metrics report, and Update metrics process and plans | Project manager hold weekly meeting on the metrics of Size, Cost & Schedule, and Quality and share the approaches with stakeholders. |
Coordinate Risk Program | Develop risk plan, Review risk plan, Evaluate its plan, schedules for risk, Collect process and product risks, Establish risk database, Perform risk assessment, Coordinate risk control, Coordinate risk meetings, and Generate Issue risk reports | Risk affects the success of project directly. Project manager lists up possible risk caused by budget, cost, and resource and share it with high level management for the success of process improvement project. |
Perform Audits | Review project plan, Develop audit plan, Review audit plan, Establish audit database, Perform process audit, Perform software audit, Perform physical configuration audit, Perform functional configuration audit, and Upgrade audit process | Encompassing all processes and sub-processes. SQA group participate to determine the documented procedure, process and so forth. The result of audit need reporting top management. |
Coordinate Review Meetings | Verity peer review schedule, Develop review template, Support peer review meetings, Track action items, Verify design review schedule, Develop design review agenda template, Coordinate design review data packs, Support design review meetings, Track design review action items | Project manager and senior developer communicate peer review and design review based on the Sprint scheduled every sprint cycle one month. |
Facilitate Process Improvement | Review project plan, Identify process improvement opportunities, Develop process improvement plan, Prepare for assessment, Perform assessment, Process assessment result, Monitor action plan and progress, and Update action plans | This process in eOne is to build the baseline for the continuous software development process improvement across software development organization. Within development project, the project manager set initiative and report current status to the top management bi-yearly. |
Monitor Test Program | Establish test metrics database, Collect test metrics, Report test metrics, Review test documentation, Monitor test execution, Plan test process improvement, Assess test process, and Develop test assessment reports | The design model, Scrum in eOne shorten the cycle of test and acquire frequent feedback from the users before moving to the next Sprint. Project manager, business analysts, and senior developer monthly based where developers and end-user feedback gets performed weekly. |
Above section has listed a number of software development processes during SDLC where the focal point of SQA include the requirements development process, product integration, and verification/validation. In building a light ERP software for eOne, the focus has to be made in both functional requirements and non-functional requirement encompassing functionality, usability, reliability, performance, and supportability (Fleming, n.d.).
Here reviews the potential benefits of each processes in relation with SQA – Requirements development, product integration, and verification/validation in the context of capacity maturity.
As reviewed in this section, the Software Quality Assurance plays important role for the software development process improvement in building quality software.
Risk is the potential harm arises from current process or future event. Risk affects software quality assurance activities which assumed quality software is the result of software process improvement. Hence, proper risk management for eOne is essential for SPI improvement since it is correlated with software quality to build. Figure 19 depicts the information and communication flows in risk management process (NIST, 2012).
Figure 19. Risk Management Process

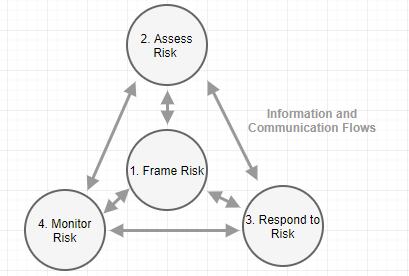

The first component of risk management addresses how to frame risk context to establish risk management strategy. The second component, risk assessment addresses how to assess risk based on the risk management strategy established. Based on the assessed risk, the third component determines how to respond to risk including alternative course of action; then the last component determines how the organization monitor risk over time.
This section discusses the importance of risk management and the key factors in risk assessment process. The success of a software development heavily depends on the amount of risk which corresponds to software development processes. Hence, it is paramount to identify, assess, prioritize, and manage the risk including understanding, mitigation plan because any risk may threaten the success of whole project itself. The benefit of using risk management in software development process are (Iversen et al., 2004),
There are various risk factors: structure of the organization, stability of requirements, socio-cultural factors, similar organizational structure, security and privacy, quality management, project size, project management, negative impact on employer's moral, modularity, knowledge management, juridical framework, interfaces in the project management, hidden costs, fluctuation, experience in the domain, experience in offshoring/competences, dependency of the internal knowledge, and architecture. This section reviews factors in a risk assessment in the context of maturity in software process improvement (Zubrow et al., 1994).
Table 11. Key Factors for Risk Assessment
Process | Risk Assessment factors |
---|---|
Requirements Management |
|
Software Project Planning |
|
Software Configuration Management (SCM) |
|
Table 11 represents factors associated with risk assessment questions on factors discovered during software development process. In this table, the purpose of requirements management is to establish a common understanding among stakeholders, which leads to an agreement to cover both technical and nontechnical requirements. Software project planning establishes reasonable plan for manage the project. And software configuration management is to build and maintain the integrity of software throughout SDLC.
This section discusses various risks which impact software process improvement initiatives in building a light ERP software for eOne. The goal of software development project is to build software which can hold daily transactions based on a heavy commercial ERP software. When compiling software development process improvement, the risks fall into project risk, product risk, and business risk.
Table 12. Risks Impacts Process
Risks | Detail |
---|---|
Software Requirement Risks |
|
Software Cost Risk |
|
Software Scheduling Risk |
|
Software Quality Risk |
|
This section discusses risk resolution strategies within SPI team to address the processes deficiencies (Iversen, Mathiassen & Nielsen, 2004). Table 13 entails the SPI risks in the scope of application – a light ERP software, framework – CMMI with Agile way, and Methodology – Sprint development model.
Table 13. Managing and Developing SPI Risks
Scope | Managing SPI Risks | Developing Risk Approaches |
---|---|---|
Application area | Management of risks in SPI teams in eOne | Develop risk management approaches for specific contexts |
Framework |
|
Framework of different types of management approaches |
Methodology | Process to manage risks in SPI teams | Process to develop risk approaches for specific contexts |
Based on the risk assessment against software development lifecycle, it is paramount to recognize and identify both weaknesses and strengths in it. The assessment process analyses eOne’s software development capabilities and compares them to the industry standards. Any findings of assessment help to educate developers by exposing any deficiencies in their processes and procedures in building quality software – a light ERP software (Zapparolli, 2008). Table 14 describes the risk during software development phases. As marked in this table, there are possible deficiencies in each processes throughout SDLC.
Table 14. Process Deficiencies in Software Development Phases
SDLC Phases | Rework | Maintenance Problem | Performance Problem | Cost Overrun | Schedule Delay |
---|---|---|---|---|---|
Planning | X | X | |||
Requirements | X | X | X | ||
Design | X | X | X | ||
Coding | X | X | |||
Testing | X | X | X | ||
Deployment | X |
Following section reviews how to mitigate the risk identified in this section.
So far, risk in processes are identified for eOne. It is time to implement its mitigation plan based the risk assessment made to improve software process. Figure 20 depicts risk mitigation planning in overall risk management process (AcqNotes, n.d.).

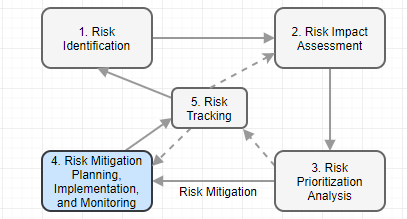

Figure 20. Risk Mitigation
Throughout the software development project, it is vital to make sure the effective communication among all stakeholders, managers, developers, and Quality Assurance team. Sharing information and getting feedback on risk will greatly increase the probability of project success. Risk management is extensive discipline, which can mitigated through,
Assumption was made that the software must be tested in each iteration of development phases for the quality assurance and potential risk in the developed software. The main purpose of this activity is to verify whether the requirements met and prevent/remove possible defects in it. This activity should be more or less same whether it complies with the traditional waterfall model or the agile methodology. Table 15 describe implementation of the risk assessed and its communication plan (Zapparolli, 2008).
Table 15. Implementation and Communication Plan
Activities | Detail | Communication Plan |
---|---|---|
Testing and Reviews |
|
Project manager, senior developer, and developer through code review and peer review for each iteration |
Defect prevention /removal /containment |
|
Project manager, business analyst, and developers through code review, test planning, and development management process documents |
Inspection |
|
Senior developer and developers through coding standards document |
Formal Verification |
|
Project manager, business analysis, and other stakeholders to verify whether the requirements are implemented correctly |
Formal Validation |
|
Project manager, end-users, business analyst through formal meeting |
This section discusses how the risk assessment, its mitigation plan are beneficial to eOne in implementing software process improvement plan. To fulfil continuous improvement in the software quality, it is imperative to develop risk approaches throughout software development processes. Figure 21 depicts possible development risk approaches which can be used for software process improvement plan (Iversen et al., 2014). In this figure the risk approaches outcome is to be used next iteration of development in organizational context using action research process.
Figure 21. Developing Risk Approaches
So far, various approaches were reviewed including the benefit of risk management, key risk assessments factors, how risk management in software development contributes software process improvement, how this approach help to mitigate its deficiencies. It is important for eOne to ensure the efforts for process improvement at the organization level as suggested above because various framework and methodology reviewed are relevant to the development of light ERP software by tackling existing and potential tasks in this project.
